New 115 kV transmission lines near Wrightsville, Arkansas
Supporting new Entergy Arkansas customer needs
Entergy Arkansas strives to provide affordable, efficient and reliable power to all our customers to meet electricity needs today and into the next generation. We are proud to serve more than 737,000 customers located in 63 counties across a robust electric system.
We are planning to modify the existing Wrightsville 115kV substation and construct two new 3.5-mile 115 kV transmission lines to a new customer-owned substation approximately one mile west of Wrightsville, Arkansas. This project will serve the recently announced Avaio Digital Partners (“ADP”) facility.
What is the purpose of the project?
ADP is constructing a new facility in the area, and the new transmission lines will supply power to the facility, contributing to the continued industrial and economic growth of the state.
What transmission line construction is needed?
Entergy Arkansas plans to construct two new 115kV transmission lines connecting the Wrightsville 115kV substation to a new substation owned and constructed by ADP. Entergy Arkansas will construct the transmission lines and related substation equipment, which includes two new 115kV circuit breakers and approximately 55 new modular pole structures.
Economic impact
The two 115kV transmission lines to be constructed will be fully funded by ADP. ADP’s new facility is anticipated to create more than 75 new, full-time jobs. This investment is expected to generate temporary construction jobs. These workers and vendors will be locally sourced where practicable. Local businesses such as restaurants, stores, service providers, and hotels will also benefit from the infusion of the new permanent jobs and construction jobs. ADP will also support the local community through the payment of property taxes.

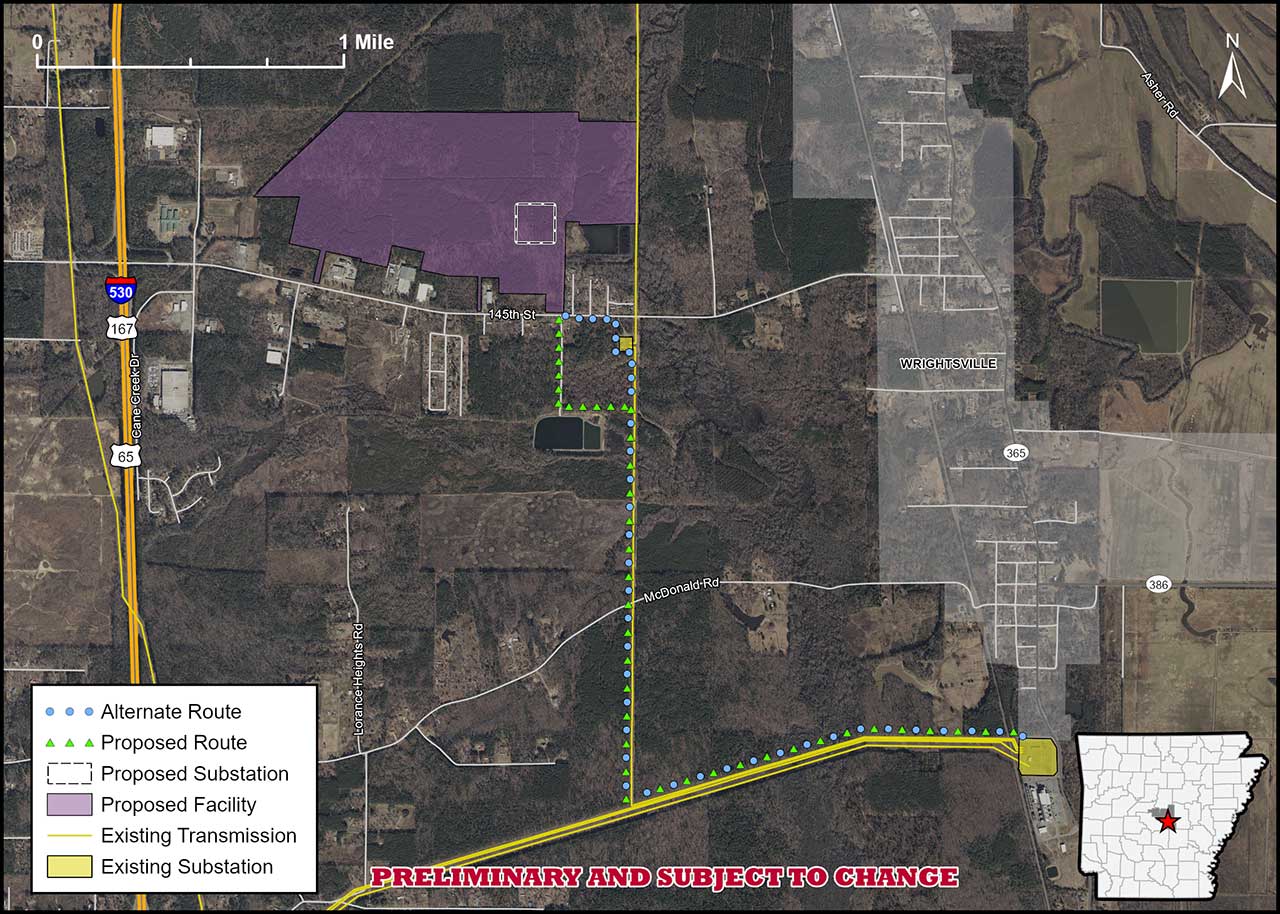

Transmission line map
Two potential routes for the transmission lines are being considered for the project as shown in the following map. The proposed transmission lines will be approximately 3.5 miles long with an approximate 140-foot right-of-way.
The proposed route of the new 115kV lines will extend from the Wrightsville 115kV substation to the ADP-owned substation located on its site. The north terminus for the transmission lines is ADP’s site located off 145th Street in Pulaski County, Arkansas. The south terminus for the transmission lines is the existing Wrightsville 115kV substation located on AR Highway 365 in Pulaski County, Arkansas. The majority of the proposed route will follow and be adjacent to an existing 115kV line. The route has been configured to mitigate impacts to natural and human resources as well as other obstacles or constraints.
The new transmission lines will be designed and built by Entergy Arkansas. Land use in the vicinity of the project consists primarily of timberland and residential areas on the north end.
Proposed route
The proposed route exits the Wrightsville 115 kV substation near the northwest corner and extends north for approximately 80 feet. From here, the proposed route trends west then southwest, paralleling the north side of the existing Wrightsville to Little Rock 145th 115 kV Transmission Line right-of-way for approximately 6,800 feet (1.3 miles). The proposed route then crosses the existing right-of-way and turns north, paralleling its west side for approximately 6,700 feet (1.3 miles). At this point, the proposed route turns west and extends approximately 1,250 feet (0.25 miles) to the west side of Thornoaks Drive / Irongate Drive. The proposed route then turns north and extends approximately 1,600 feet (0.3 miles) crossing 145th Street and terminating along the southern boundary of ADP’s property.
Alternate route
The alternate route exits the 115kV Wrightsville substation near the northwest corner and extends north for approximately 80 feet. From here, the alternate route trends west then southwest, paralleling the north side of the existing Wrightsville to Little Rock 145th 115 kV Transmission Line right-of-way for approximately 6,800 feet (1.3 miles). The alternate route then crosses the existing right-of-way and turns north, paralleling its west side for approximately 7,700 feet (1.5 miles). At this point, the alternate route turns west, paralleling the southern boundary of the 145th Street Substation for approximately 300 feet before turning north and extending an additional 560 feet. The alternate route then turns west and extends approximately 800 feet before turning northwest, crossing 145th Street, and terminating along the southern boundary of ADP’s property to the west of Thornoaks Drive / Irongate Drive.
Schedule overview
Anticipated time frame
Planned activities
Fourth quarter 2025 – Third quarter 2026
Development activities, including resource assessment, environmental studies, interconnection studies, engineering, APSC regulatory review, and permitting
Fourth quarter 2026
Right-of-way clearing
First quarter 2027 – Second quarter 2027
Transmission lines construction
June 2027
Transmission lines in service
Transmission lines and right-of-way considerations
Entergy Arkansas intends to make improvements in collaboration with community members and key leaders. All final decisions regarding new transmission line facilities will be made only after considering public input through the following sources:
- Customer feedback – Input from our customers, area landowners, residents and community leaders are essential in developing an effective and efficient project plan. We welcome you to provide any feedback through this comment form.
- Public open house – We developed this webpage for the public to review the proposed project requirements. The webpage offers an email ([email protected]) for members of the community to offer comments or send in questions. You may also call 501-213-0706 to leave a detailed message. Your call will be returned by one of our subject matter experts as soon as possible.
- Notice to landowners – All landowners of record on or near the proposed project area have been notified by mail.
Several factors must be considered when embarking on a project of this scale, including:
- Right-of-way for the transmission line and facilities – We will design the transmission line and facilities using existing standards for 115 kV right-of-way up to 140 feet wide based on utilization of single-pole modular structures. Additional right-of-way and/or substation terminal facilities may be required above 140 feet to accommodate guy wires, angle structures, terminating facilities and for clearing risk trees;
- Aesthetic considerations and other environmental factors – Modular poles will be used to provide tangent, angle turns, and dead ends for the transmission line. These types of transmission line structures were selected to minimize the aesthetic displeasure of the installation;
- Health and safety – Safety is our priority and, in accordance with the requirements set forth in the National Electrical Safety Code, we will construct and operate the proposed electrical facilities at its standard voltage design and will observe reasonable safety precautions to prevent jeopardizing the public safety. Construction methods and activities in the field will also meet U.S. Department of Labor Occupational Safety and Health Organization requirements. Entergy Arkansas also maintains and follows its own safety policies and procedures in the Entergy Transmission and Distribution Safety Manual;
- Regulatory and permitting – The APSC requires us to file an application for approval of a Certificate of Public Convenience and Necessity to construct the proposed 115 kV transmission lines. The APSC may conduct a public hearing in connection with our application. The purpose of the hearing would be for the commission to hear evidence of the general impact of the project and to determine the reasonableness of the proposed route for the transmission lines, as opposed to individual objections to the presence of the facilities, and to approve a route that minimizes generally adverse economic and environmental consequences. However, compensation for any claimed damages will not be awarded by the APSC, but rather, such damages would be considered by a circuit court in the appropriate jurisdiction. Additionally, the U.S. Army Corps of Engineers, as well as other federal and state agencies, requires Entergy Arkansas to file for approval of various permits for the new transmission line.
Next steps
- Customer contact and site access – Landowners will be contacted for assistance in developing plans to temporarily access new right-of-way prior to construction. These plans may include ground surveys, soil testing and test borings.
- Construction phase – The proposed electrical facilities will be designed and constructed under the direction, supervision and design specifications of Entergy Arkansas. Vegetation management, electrical construction and final testing will be performed by pre-qualified electrical contractors under the supervision of our personnel in a sequential operation of surveying, clearing, structure erection, conductor installation, testing and clean-up. The first operation is to survey the transmission route to establish the centerline, edge of right-of-way and profile of the transmission line. Centerline staking and profiling may require cutting some trees and undergrowth. Right-of-way clearing, if necessary, will also be performed by contracted crews under the supervision of our personnel. Trees outside of the right-of-way that endanger the safe and reliable operation of the transmission line will be cut to provide necessary clearance.Structure installation takes place in three phases: transporting, assembling, and erecting. Material is transported to each location where structures are assembled, as much as is practical, on the ground; the poles are then set according to the appropriate construction method based upon soil type. Once the structure is assembled, installing conductor is the next critical step. Many vehicles and items of equipment are required to install the conductor. As with vehicles and equipment associated with other construction phases, crews will exercise care to minimize damage to the terrain and landowner premises.
Frequently asked questions
What experience does Entergy Arkansas have in building transmission lines?
We own and operate approximately 938 circuit miles of extra high voltage transmission lines of 345kV or greater; 195 circuit miles of transmission lines of 230kV; 3,801 circuit miles of transmission lines of 161kV and lower; as well as transmission substations, distribution substations and associated substation facilities necessary to provide electric service to the region.
What is the project’s timeframe?
While this project still needs to be approved by the Arkansas Public Service Commission, we expect to begin construction in the fourth quarter of 2026 with completion scheduled for the end of the second quarter of 2027.
Should I be concerned about safety issues?
We prioritize having a safe, accident-free environment. Detailed on-site safety measures will be developed to meet the specific needs of the project, community, and impacted areas.
How big is the footprint of the transmission project?
The proposed 115kV transmission lines would be approximately 3.5 miles in length sharing an associated 140-foot right-of-way, totaling approximately 60 acres.
Who will pay for the transmission project?
This project is funded entirely by ADP.
Where should I direct any questions or concerns regarding this project?
Questions and comments can be submitted by emailing the questionnaire to the project specific email address ([email protected]) or by calling 501-213-0706 and leaving a detailed message. Entergy Arkansas representatives will monitor feedback and answer address any questions you may have.
